Project Summary

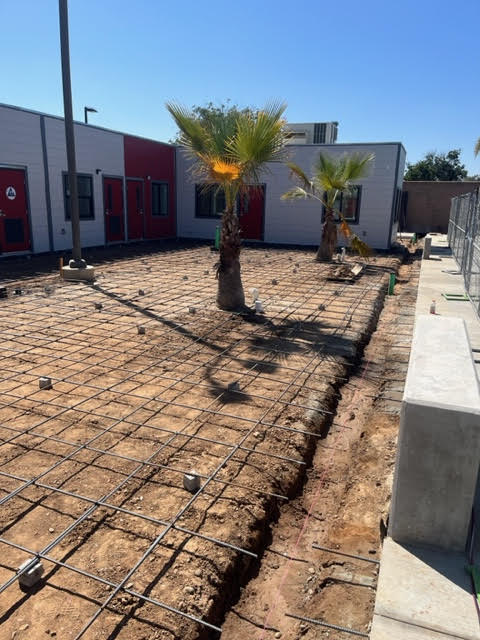

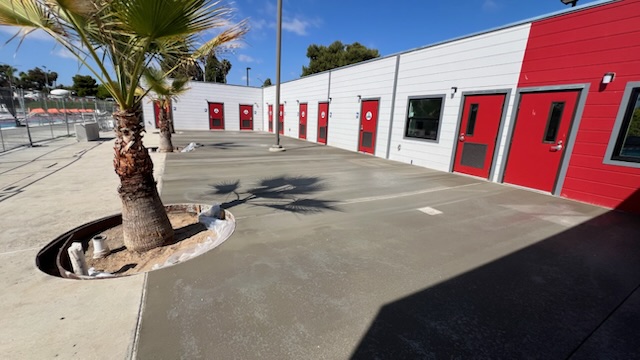

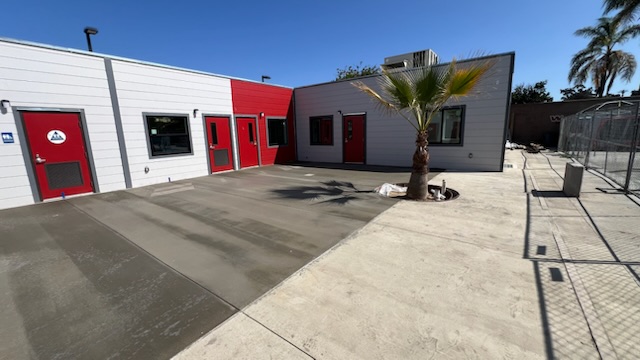

The project will replace the two existing park restrooms with new restrooms; construct a new patio area, ADA improvements and utility connections to support modular pool support buildings on the east side of Las Palmas Pool; install shade canopies around the kids pool; install new bleachers on the west side of the pool; and provide new fencing, landscaping and drainage improvements.
Timeline
See the project timeline below for Las Palmas Park Improvements.
Funding

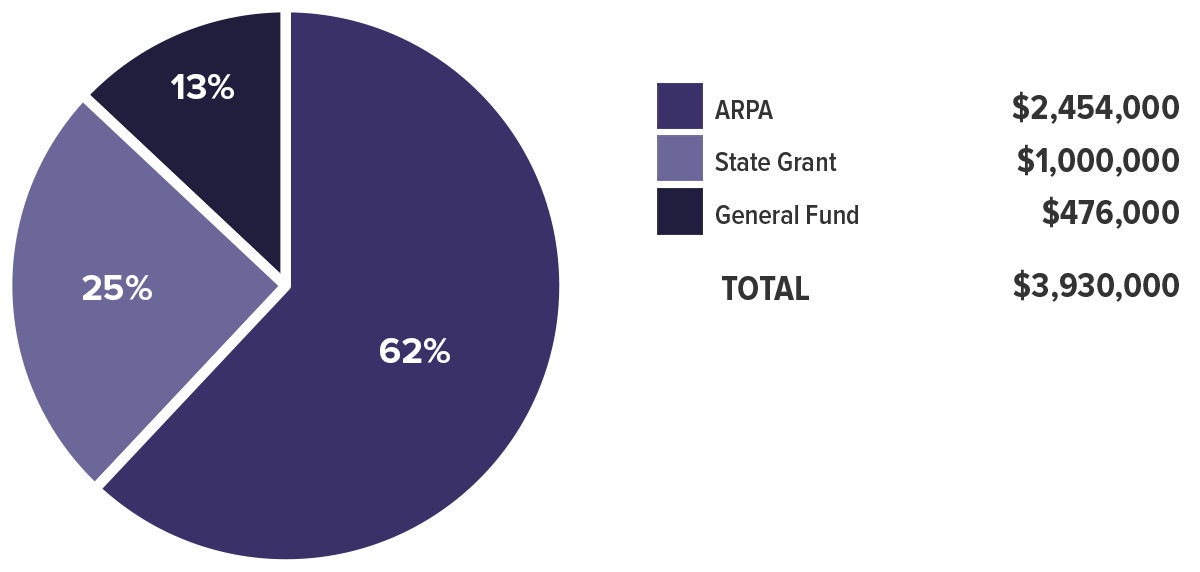

See the funding sources below for Las Palmas Park Improvements.
Project Updates
DATE:
April 17, 2026
Past 2 Weeks

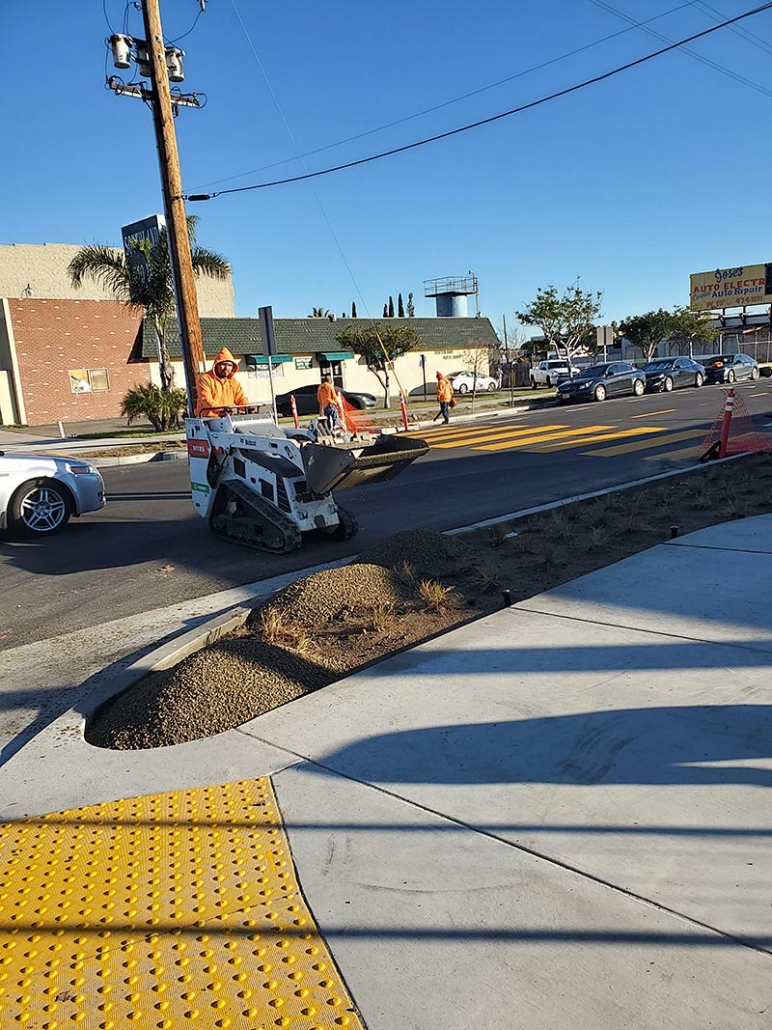

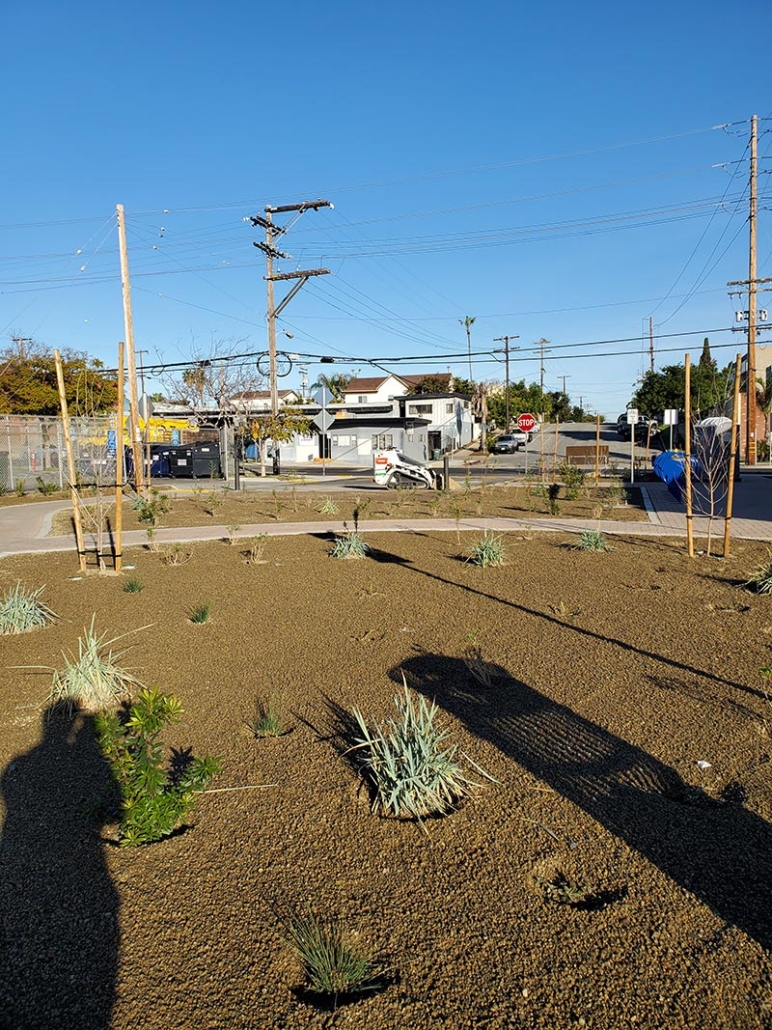

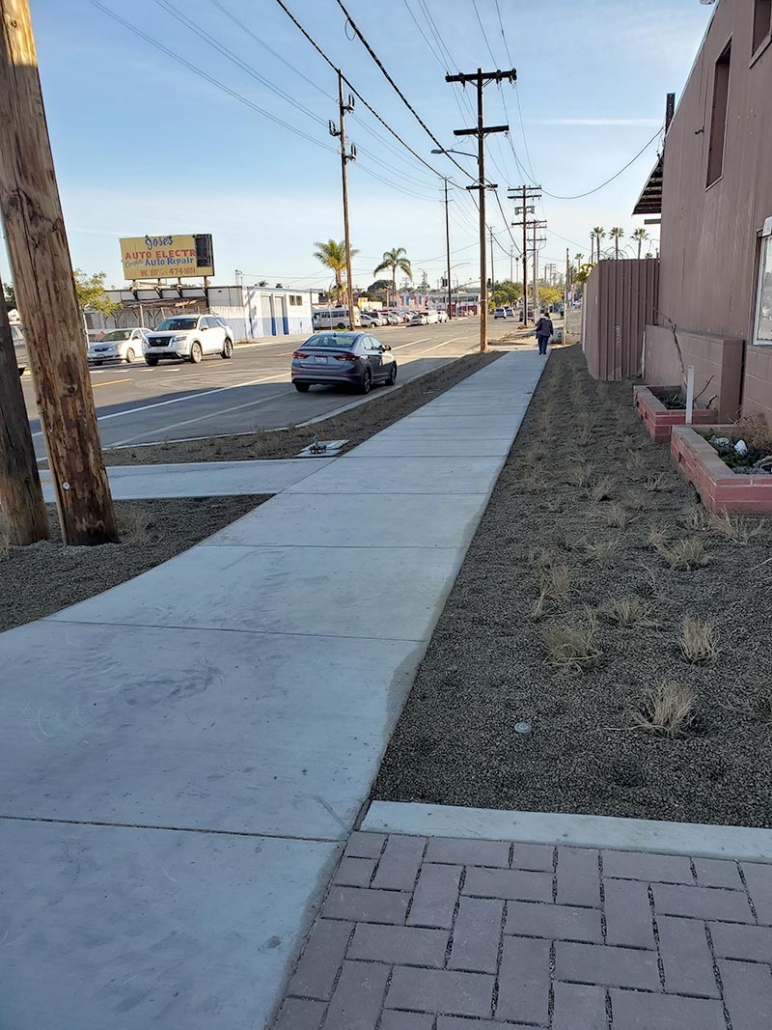

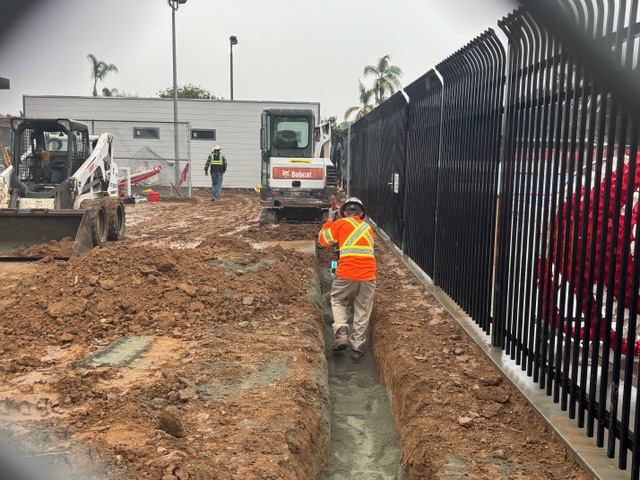

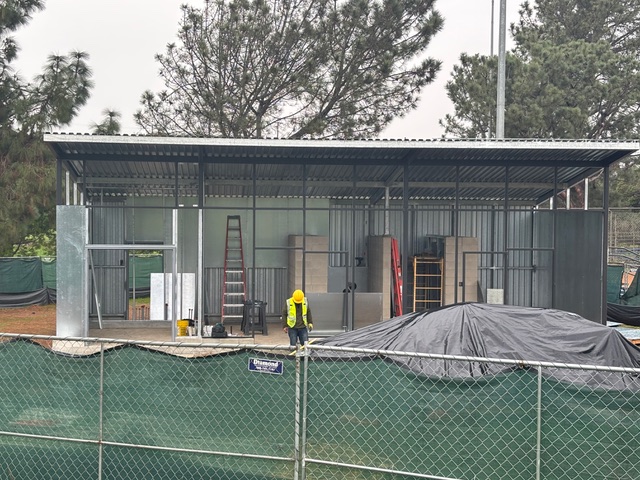

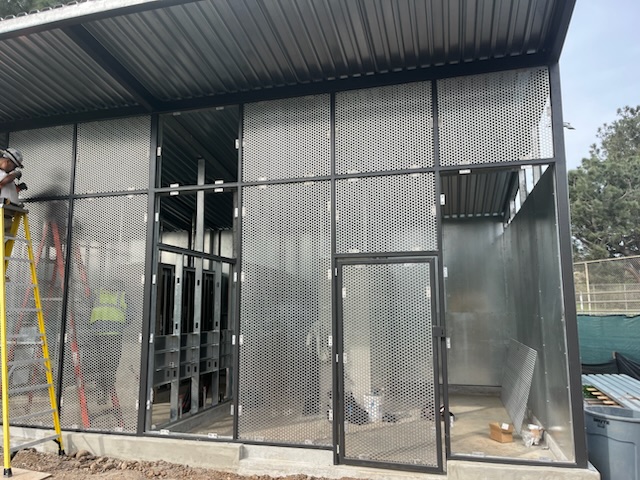

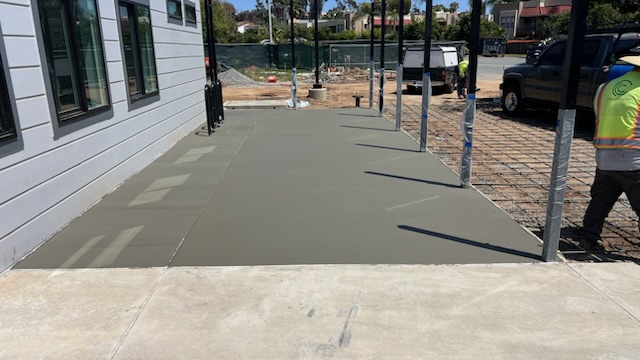

- Modular Buildings – Demolition of sidewalk, curb and gutter and preparing to pour new sidewalk, curb/gutter and driveway

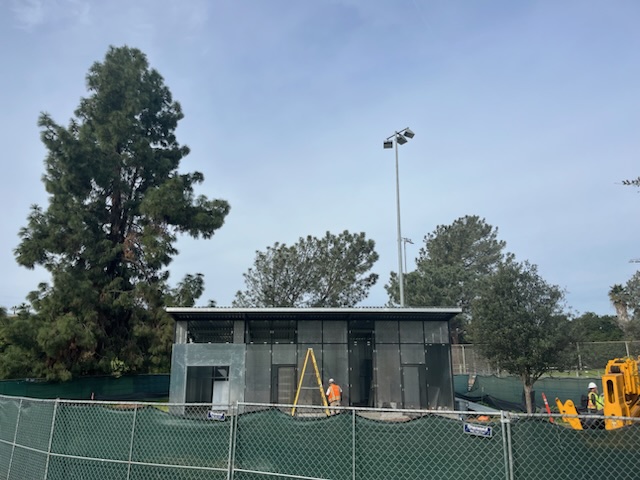

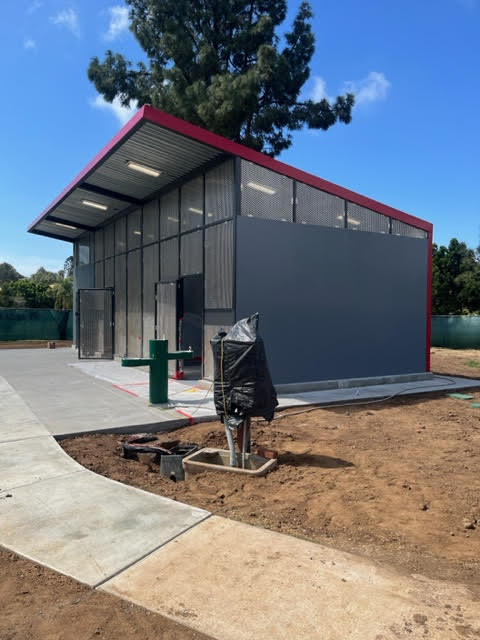

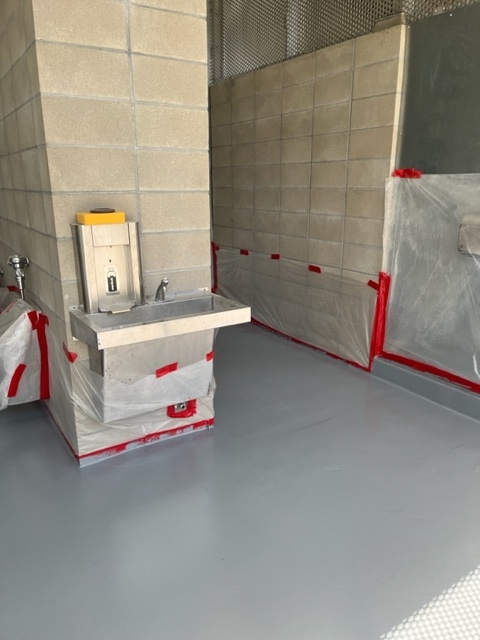

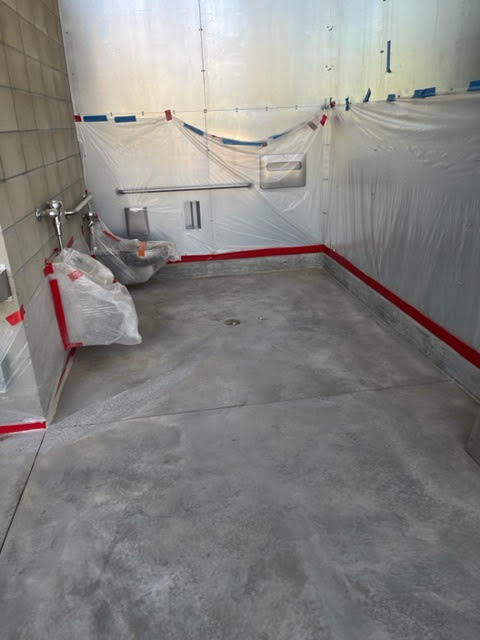

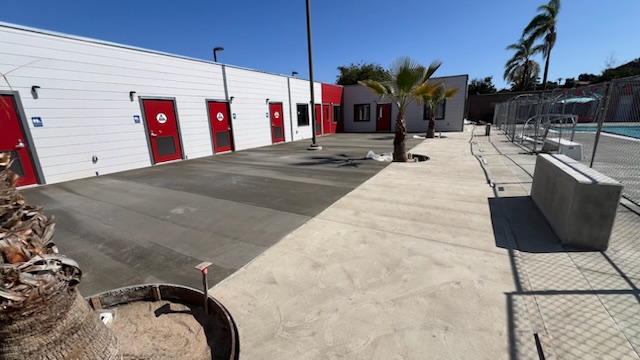

- Restroom #1 and Restroom #2 completed
2 Week Look Ahead
- Modular Buildings – Pouring new sidewalk, curb/gutter and driveway
- No streets will be impacted at this time
- Main pool open for normal operating hours during construction
Project Team
Contractor:
Company Name
Contact Name
Address
City, State, Zip
Phone
Email
Project Manager:
Project Professionals Corporation
Josh Johnson, PE
4700 Spring Street, Suite 100
La Mesa, CA 91942
858.634.8180
Administrator:
City of National City
Steve Manganiello, TE
1243 National City Blvd
National City, CA 91950
619.336.4380
